Skip to main content
Lakewood Village Building Services
Thursday, November 21st, 2024 🔒 Staff Access
Home Building Application
  • Building Application
    Builder Information
    123 Main St.
    555-867-5309
    First and Last Name
    555-867-5309
    example@domain.com
    Property Information
    First and Last Name
    Lot # & Block #
    Sub Contractor

    All contractors who are required by state law or local ordinance to be licensed must register with the Town of Lakewood Village before performing any work.

    Online registration can be completed by accessing the form at building.lakewoodvillagetx.us

    Plumbing Subcontractor
    First and Last Name
    555-867-5309
    example@domain.com
    Electrical Subcontractor
    First and Last Name
    555-867-5309
    example@domain.com
    Mechanical Subcontractor
    First and Last Name
    555-867-5309
    example@domain.com
    Authorized Agent
    First and Last Name
    example@domain.com
    Notice

    This permit shall become null and void if work or construction authorized is not commenced within one hundred eighty (180) days, or if work or construction is suspended or abandoned for a period of one hundred eighty (180) days at any time work is commenced.

    I hereby certify that I have read and examined this application and know the same to be true and correct. All provisions and laws and ordinances governing this type of work will be compiled with whether specified herein or not the granting of a permit does not presume to give authority to violate or cancel the provision of any other state or local law regulating construction or performance of construction.

    The Town of Lakewood Village does not keep any personal information about you or your visit to our Internet site unless you have specifically supplied it to us. In cases where you have supplied us with information or sent us an email, such information will be treated in accordance with the applicable provision of the Public Information Act. This means that such information may be considered public information available to the public upon request. To the extent allowed by the Act and opinion of the Attorney General, the Town will make reasonable efforts to protect personal and financial information from disclosure.

    I agree to the terms and conditions.
  • Building Code Compliance
    Goal

    The focus of plan review and building inspections are to ensure quality construction. As the builder, you shall require your designer, engineer, and subcontractors to draw, specify, and build structures that reflect the code requirements and other regulations adopted by the Town. Our best effort will achieve the goals of safety, energy efficiency, and quality construction.

    Building Codes
    • 2018 International Energy Conservation Code
    • 2017 National Electrical Code
    • 2018 International Residential Code
    • 2018 International Mechanical Code
    • 2018 International Plumbing Code
    • 2018 International Fuel Gas Code
    Energy Conservation
    Minimum

    LATEST INTERNATIONAL ENERGY CONSERVATION CODE ADOPTED BY THE STATE OF TEXAS

    Preferred

    ENERGY STAR HOMES

    Requires third-party rater plan review and inspection/testing by RESNET agency certified for the State of Texas. Voluntary compliance shall require two complete copies of rater analysis with building plan submission for building permit. Raters A/C must be within 1% of plan/permit area. Builders shall employ the same rater for plan review, inspection, and testing.

    A third-party verification form must be filled out, indicating final “HERS” rating score prior to the builders request for final inspection and Certificate of Occupancy.

    The Town shall not issue a Certificate of Occupancy until all required documentation have been submitted and verified to be in compliance with EPA regulations.

    RESCHECK OR IC3 ENERGY ANALYSIS

    ResCheck or IC3 Energy analysis shall be signed by an ICC certified energy inspector / plans examiner.

    Lessons Learned

    The intent of this section is to provide guidance for builders or general contractors regarding the deficiencies commonly found during inspections. As the builder, you shall require subcontractors to build structures that reflect the code requirements and other regulations adopted by the Town. Our best effort will achieve the goals of safety, energy efficiency, and quality construction.

    The following information is provided as reference and shall not be considered all inclusive:

    T-Pole

    • Address and permit posted shall be onsite.
    • Ground fault protection shall be included on all 20 and 30 amp circuits.
    • Pole shall be braced and grounded.
    • Plugs and breakers shall be contained in a weather proof enclosure.

    Plumbing Rough

    • Address and permit shall be posted onsite.
    • Proper fittings shall be used in system.
    • Short sweep fittings shall be prohibited under slab.
    • Vents, traps, and trap arms shall be properly sized.
    • Minimum ¾ inch water service with cut-off valve shall be installed.
    • Minimum twenty (20) foot copper service line to inside forms, no PEX shall be allowed under slab.
    • Hose bibb with tamper proof vacuum breaker shall be installed. Water shall be on to dwelling or be air tested to a minimum fifty (50) psi.
    • Copper lines shall be sleeved, taped, or painted where exposed to concrete.
    • All dwelling sewers (yard lines) shall be a minimum four inch (4) with a four inch (4) double or two-way cleanout.
    • Turns in sewers shall be achieved with one-eighth (1/8) or one-sixteenth (1/16) bends. Short radius fittings shall be prohibited.
    • Water and sewer lines shall be in separate trenches or in a common trench with water line placed on a solid shelf twelve inches (12) above sewer line.
    • All underground PVC and copper shall be bedded with sand or clean soil.
    • Form board survey shall be available for the Building Official.

    Water & Sewer Taps

    • All taps shall be closed and buried the next day upon passing the inspection.

    Foundation

    • Address and permit shall be posted.
    • Post tension or other engineered plans shall be on jobsite at time of inspection.
    • Minimum concrete thickness shall be four inch (4) or greater.
    • Beam width and depth shall comply with approved engineer designs.
    • Chairs shall be under reinforced steel and tendons.
    • Exposed copper shall be sleeved and protected.
    • All PVC DWV lines in beams shall be wrapped protected from concrete.
    • Forms shall be adequately braced, with brick ledge installed if applicable.
    • Block-outs for tubs and showers shall be in place.
    • Anchorage shall be in place at time of inspection.
    • Approved engineer inspection report shall be onsite.
    • Rough grading for positive drainage away from slab shall be compete after concrete placement and removal of forms.
    • All weight tickets shall be on file with the Town prior to next inspection.

    Flatwork

    • Town sidewalks shall be minimum 4’ wide with 1/4" per foot slope from property line to street.
    • Expansion joints shall be installed where abutting existing concrete and every twenty (20) feet.
    • Reinforcement shall be #3 bars at 18” on center each way.
    • Sidewalk marking for control joints shall be five feet (5) on center.
    • Drive approaches shall be six (6) inches in depth and reinforced with #3 rebar dowelled into existing concrete at eightteen (18) inch on center placed on compacted soil.
    • Water meter boxes shall be flush to final grade, including sod, and meters and fittings shall be fully accessible.
    • Water meters shall not be located in any flat work.
    • Handicap ramps shall conform to the Texas Accessibility Standards (T.A.S.).
    • All fire hydrant and main line cut-off valves shall be clearly located and be flush to final grade.

    Plumbing Top Out

    • All vents shall extend through roof minimum 6” with flashings properly installed.
    • Properly size vents, traps, and trap arms.
    • Horizontal vents below forty-two (42) inches above floor shall be prohibited.
    • All plumbing shall be stack vented. Flat venting shall be prohibited.
    • All water pipes in exterior walls shall be insulated.
    • All copper lines and stub outs shall be strapped and supported.
    • All plumbing walls shall require minimum 2” X 6” framing.
    • All water heaters shall be in an approved drip pan. T and P lines and drain lines shall terminate to the exterior of the building.
    • A water test shall be required on all plumbing above slab regardless of the number of stories of the finished dwelling.
    • Cleanouts shall be installed above arm tie-ins.
    • Approved shower pans shall be installed and tested.
    • All shower valve risers shall be capped and tested.
    • All exterior hose bibs shall be frost proof and protected where passing through masonry material.
    • Water heater installations shall comply with adopted IECC requirements.
    • Air admittance valves shall not be installed without prior approval from the Building Official.

    Mechanical Rough

    • Flex duct shall be properly supported and turns made in a manner that will not restrict air flow.
    • Approved splice connectors shall be used at joints in duct work.
    • All duct insulation shall be minimum R6.
    • Primary condensate drains shall tie into a wet trap.
    • Bath exhaust fans shall terminate to the exterior of structure.
    • Dryer vent shall be metallic duct with maximum length of twenty-five (25) feet, with no more than two (2) ninety (90) degree bends. Two (2) feet shall be deducted for each ninety (90) degree fitting.
    • Insulation on A/C refrigerant lines shall comply with the adopted IECC.
    • All seams and joints in metallic duct boots shall be sealed with mastics.
    • Mechanical storage equipment areas shall comply with adopted IECC.
    • All plenum spaces shall be in compliance with adopted IRC requirements.
    • All wood burning or gas fireplaces shall have fresh air intake from outside of structure.

    Sheating and Nailing Pattern

    • Wind bracing shall comply with the adopted IRC nailing schedule.
    • Seems and joints shall be exposed.

    Framing

    • All bottom plates on masonry or concrete shall be pressure treated. Plates will be secured in compliance with the adopted IRC.
    • Joist and rafter spans shall be installed per span charts.
    • Valleys, hips, and ridges shall be no less than two (2) inch nominal thickness and not less in depth than the end cut of the rafters.
    • Purlins shall be at least the same size as the rafter, with struts four (4) feet on center.
    • Joists over four (4) feet in length that terminate other than on a bearing wall shall be pressure blocked or joist hangers must be installed.
    • Fur downs, chimneys, ceilings of different heights, vertical wall spaces over ten (10) feet in height, roof lines, and open risers on stairs shall be fire blocked.
    • Stairs, landings, handrails, and guardrails shall comply with the adopted IRC.
    • Metal fireplaces shall be installed according to manufactures specifications.
    • Vapor barrier shall be installed at brick ledge behind sheathing.
    • Brick ties shall be in place where applicable.
    • Masonry supported by wood members shall comply with the adopted IRC.
    • Any beam / ceiling joist over four (4) with an opposing load shall be TRIPPLED regardless of span.

    Electrical Rough

    • Aluminum or copper clad aluminum conductors prohibited.
    • Panel shall be grounded to cold water piping and supplemental ground rod or UFER ground.
    • Bonding strap or screw shall be installed.
    • Receptacles shall be installed per adopted IRC requirements.
    • All Romex in return air spaces shall be sleeved.
    • All branch circuits that supply 125 volt 15 and 20 amp outlets in dwelling unit bedrooms shall be Arc Fault protected.
    • Smoke detectors shall be installed per adopted IRC requirements and manufactures installation instructions.
    • All Romex extending through masonry shall be protected.
    • Bonding / grounding bushing shall be installed a service nipple where applicable.
    • All electrical wiring shall be 12 AWG wiring.

    Insulation

    • A copy of the third-party insulation inspection shall be received by the Town prior to next inspection.

    Electrical Release for Meter

    • Conduit and disconnect shall be installed for A/C condensers.
    • Connections shall be made up at meter base and panel.
    • Cold water and ground rod clamps shall be secured in place.
    • All receptacles, switches, and fixtures shall be in place or blanked off.
    • HVAC equipment shall be installed and wiring in place.

    Gas Release for Meter

    • Low pressure systems shall be air tested at fifteen (15) psi. Medium pressure systems shall be air tested at sixty (60) psi.
    • All gas supply openings shall have valves; any un-used openings shall have a valve and a cap.

    Buliding Final

    • Water meter and valve boxes shall be set to grade and cleaned out so connections and valves are visible.
    • Cracked / broken sidewalks or approaches are prohibited.
    • Final grade, positive drainage, swell location, and sod must be in place.
    • Smoke detectors shall be in place and operable.
    • Required exit hardware shall be installed.
    • Weather stripping shall be installed at all exterior doors.
    • Windows shall be free of cracks or breaks.
    • A/C unit shall be operational and mounted on level concrete pad.
    • Window screens shall be installed.
    • House numbers of contrasting colors shall be installed at front of house.
    • Blown insulation shall be in place with certification paperwork at attic entrance.
    • GFCI's shall be operational at all locations.
    • All outstanding fees shall be paid in full.
    • Final grade survey shall be on site at time of inspection.
    • Notarized termite letter shall be on site at time of inspection.
    • Customer Service Inspection letter shall be filled out and signed by licensed plumber or TCEQ licensed CSI inspector.
    • Energy rough and energy final inspection approvals.
    • The irrigation permit and back-flow test report shall be onsite if irrigation system has been installed.
    • Dwelling shall be move-in ready and lot and street shall be clean from debris and mud.

    Notice

    I hereby certify that I have read and examined the Town of Lakewood Village Building Code Compliance form and understand the “Lessons Learned” section is provided as a reference aid in the compliance of all required building codes and ordinances adopted by the Town of Lakewood Village.

    I agree to the terms and conditions.
  • Building Permit
    Goal

    The focus of plan review and building inspections is to ensure quality construction. As the builder, you shall require your designer, engineer, and subcontractors to draw, specify, and build structures that reflect the code requirements and other regulations adopted by the Town. Our best effort will achieve the goals of safety, energy efficiency, and quality construction.

    Permit Application

    Steps

    1. Residential new home construction permits consist of five (5) components, which must be filled out, dated, signed by the builder and his/her registered mechanical, electrical and plumbing contractors and filed with the Town:
      1. Application for Building Permit.
      2. Mechanical.
      3. Electrical.
      4. Plumbing.
      5. Concrete / Flatwork.
    2. All forms are available on the Town's website @ lakewoodvillagetx.us/departments/building/building-services or by email @ building@lakewoodvillagetx.us.
    3. All forms listed in the Builders Packet shall be complete, legible, and signed with all applicable fees paid in full prior to the issuance of permits.
    4. Construction addresses shall include the legal description including lot number, block, and subdivision phase.
    5. All information regarding building description and materials shall be accurately and completely depicted on the site plans.
    6. All contractors shall be registered with the Town prior to the issuance of permits.

    Work Stop

    Whenever any work for which a permit is required has been commenced without first obtaining a permit, all construction shall be stopped, and a special investigation shall be made before a permit may be issued for such work. An investigation fee, in addition to the permit fee shall be collected whether a permit is then subsequently issued. The investigation fee shall be equal to the permit fee set forth in the fee schedule of the appropriate ordinance.

    Building Plan Submission Package

    Steps

    1. Submittal for approval house plans containing lot dimensions, plan footprint, setbacks (front, sides and rear) complete address, lot number, and subdivision phase, easement locations, culvert drainage (if required), names of Engineers and Builders, finish pad elevations and finish floor elevations, topographical survey, driveways, sidewalks, fence locations, lot area, slab area and coverage percent. Utility and easement locations will also be required.
    2. Foundation designs and Engineer’s letters which must have the original signature.
    3. Floor plans, elevations, framing, roof, electrical, mechanical (HVAC), plumbing and “to be built options” shall be clearly shown and detailed. Single sheet submittals are not acceptable. Options reflecting additional buildable space shall be identified by the actual square footage area and included in the permit values for total dwelling area and/or construction area under roof. Other options shown but red lined shall be included within the permit value.
    4. Elevation drawings shall clearly state exterior requirements set by the Town. Masonry calculations are an acceptable alternative (e.g., Front % + Right % + Left % + Rear % = total masonry %)
    5. All drawings shall be legible and show proper square footage for dwelling and total building areas.
    6. Energy analysis (e.g., MecChech, ResCheck or Energy-Star).
    7. All third-party rater information and documentation shall be submitted if Energy Star Home.

    Plan Review Process

    Steps

    1. All plans shall be submitted to the Town for review.
    2. Plans are reviewed in the order that they are received.
    3. The Town shall complete a plan review twenty-one (21) calendar days from the filing date for complete submittal package. The Town may require an additional twenty-one (21) calendar days for review if a submission is deemed incomplete. Common types of omissions and/or errors include but are not limited to the following:
      1. Incomplete and unsigned permit application.
      2. Missing documents.
      3. Not identifying tempered glass.
      4. Missing square footage summary on cover sheet of drawings.
      5. Not providing operable window sash where required.
      6. Not identifying installation and location of smoke detectors.
      7. Improper drawing sheet size.
    4. Building permits and red lines on a returned drawing will show any special condition that applies to the structure. This information has been added to assist the builder, field supervisors and building inspector.

    Pre-Construction Meeting

    Steps

    1. The building inspector will review the redlined plans. One (1) set of plans on sheet size 22” x 34” is preferred in addition to the redlined plans.

    Notice

    I hereby certify that I have read and understand the requirements of the Town of Lakewood Village Building Permit and Plan Review Procedures.

    I agree to the terms and conditions.
  • Building Procedures
    Inspections

    Inspection Scheduling

    Online requests will be accepted until 12:00 pm for an inspection within 48 hours.

    building.lakewoodvillagetx.us

    Inspection Results

    Inspection results will be emailed to the primary contact for the job.

    Terms and Conditions

    The Residential Code adopted by the Town defines the procedures for general contractors and subcontractors. The information below is provided as a reference and has been identified as the most relevant to residential home construction.

    1. Ensure elements in Building Permit include drainage plans and MECcheck compliance with all actual dimensions, including foundation plans, site plans. Drainage plan must have grade, elevations, show all flatwork, and the direction of water flow.
    2. A building permit fee is due upon submission of plans for approval. The fee is calculated per square foot of conditioned area for new single-family residential structures. A plan review, inspections and 4 re-inspections are included in the cost of the permit. Major remodels and accessory structure permit fees shall be based on the number of inspections required.
    3. Reinspection fees are due prior to the issuance of the Certificate of Occupancy.
    4. It is the builder’s responsibility to comply with all building related regulations. The Town assumes NO liability for compliance based on the issuance of building permits or Certificates of Occupancy.
    5. Trash containers provided by the Town’s contracted refuse provider shall be onsite prior to framing and shall remain on site until final grading.
    6. The grass shall be maintained at a height less than the requirement allowed in Property Maintenance Ordinance. The requirement includes but is not limited to ditches and easements.
    7. Vehicles are prohibited from parking on or accessing a construction site from an easement. Damage to utilities from unauthorized access shall be repaired by the Town’s Public Works department at the expense of the builder or general contractor.
    8. Water meters are set by the Town’s Public Works department.
    9. All construction and delivery traffic shall adhere to the Gross Vehicle Combination Weight (GVCW) for Town roads as per Weight Ordinance.
    10. Inspections will be performed during construction at stages listed below. All inspections will be based on adopted International Residential Building Codes and all appendices thereto, as amended by the terms of the building ordinance:
      1. T-Pole.
      2. Water service line and sewer lateral line.
      3. Rough plumbing and form board surveys are due and shall be available onsite.
      4. Foundation and/or pier and beam shall be inspected by the engineer and a stamped approval letter shall be provided to the building official.
      5. Foundation pre-pour.
      6. Sheathing / Nailing Pattern.
      7. Seconds inspection - includes the following:
        1. Frame;
        2. Mechanical Rough;
        3. Electrical Rough; and
        4. Plumbing Rough;
      8. Insulation shall be inspected by a third-party energy inspection company and a stamped approval letter shall be provided to the building official at Building Final.
      9. Drywall.
      10. Four (4) foot brick inspection (every third brick should be removed for wash out) or stucco inspection.
      11. Electric release.
      12. Gas release, if applicable.
      13. Flatwork and/or approach pre-pour.
      14. Building Final
      15. All items must be inspected prior to cover-up (i.e, concrete and sheet rock).

        If any inspection is RED tagged, submit a request for a re-inspection upon correction of violation.

    11. Certificate of Occupancy (CO) shall be issued, at no charge, upon successful final building inspection. The dwelling shall remain unoccupied until the Certificate of Occupancy has been issued.
    12. Once building plans are approved, NO changes to the plans or specifications will be accepted unless approved by the Town of Lakewood Village.
    13. Construction work times are 7:00 a.m. - 7:00 p.m. Monday through Saturday. Final stages of interior finish work may be completed on Sunday between 7:00 a.m. – 7:00 p.m. in a manner that does not create a noise nuisance.
    14. The Town shall periodically update the procedures above to reflect building code changes, newly adopted ordinances and/or any other information pertinent to construction. It is the responsibility of the builder or general contractor to ensure no updates have occurred before a new construction project is initiated.

    Notice

    I hereby certify that I have read and understand the terms and conditions of the Town of Lakewood Village Building Procedures.

    I agree to the terms and conditions.
  • Electrical Wiring Requirements
    Terms and Conditions

    The Town of Lakewood Village shall require all new electrical wiring to be 12 AWG per the adopted NEC and adopted IRC Ordinances as adopted by the Town of Lakewood Village.

    Refer to the Town of Lakewood Village Ordinances, Electrical Code and Residential Code. The Ordinances may be downloaded from the Town’s website @ www.lakewoodvillagetx.us/ordinances.

    Installation of 14 AWG wiring is strictly prohibited in the Town of Lakewood Village.

    Notice

    I hereby certify that any non-compliant wiring shall be removed and correct size installed at no expense to the Town of Lakewood Village.

    I agree to the terms and conditions.
  • Outdoor Lighting Requirements
    General Outdoor Lighting

    1. Outdoor lighting fixtures using lamps or bulbs, regardless of the number of bulbs and level of initial lamp lumens, shall not exceed 3,000 kelvins and meet the following:
    2. Initial Lamp Lumens Shielding Requirement
      ≥ 1,500 Fully
      ≤ 1,499 None
    3. All new outdoor lighting shall not cause light trespass and shall protect properties from glare and excessive lighting. Outdoor lighting fixtures shall be sufficiently shielded and aimed such that spillage of light onto adjacent properties is minimized and glare from the light emitting and/or reflecting parts of a luminaire is not visible from an adjacent property.
    4. Sag-lens, drop-lens and mercury vapor fixtures are prohibited.
    5. The installation of any barn light fixture for use as outdoor lighting is prohibited unless the fixture includes a full opaque reflector instead of the standard translucent lens.
    6. Outdoor up lighting is prohibited, except in cases where the fixture is shielded by a roof overhang or similar structural shield that will not cause light to extend beyond the structural shield.
    7. Up lighting and down lighting of flagpoles on private property is permitted:
      1. Flagpoles illuminated from below are limited to a height of 25 feet above ground level and shall be illuminated with a single spot-type fixture whose maximum initial output is 52 lumens per foot of height, measured from the light fixture to the top of the flagpole. The maximum output shall be 1,300 lumens and 3,000 kelvins. The fixture shall be mounted perpendicular to the flagpole and the light outputs shall point straight up at the flag.
      2. Flagpoles illuminated from above shall utilize a single light fixture, not to exceed 800 initial lamp lumens and 3,000 kelvins, attached to the top of the flagpole.
      3. If the flag of the United State of America is displayed during the hours of darkness it should be illuminated as recommended in the United States Flag Code (36 U.S.C. Paragraphs 173, 174).

    Refer to the Town of Lakewood Village Ordinances, Dark Skies Lighting Ordinance. The Ordinances may be downloaded from the Town's website @ www.lakewoodvillagetx.us/ordinances.

    Dark Sky Friendly Lighting - At Home

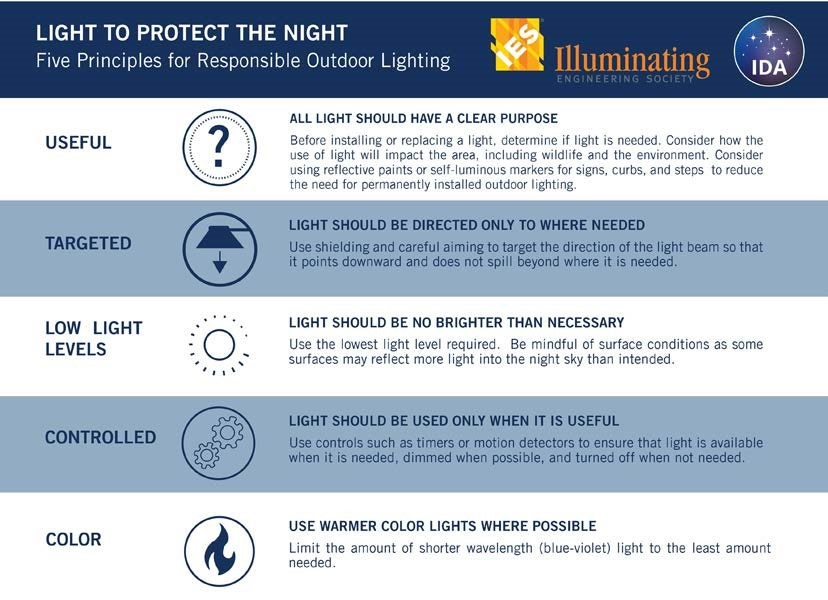

    IDA's Dark Sky Friendly Home Lighting program is based on the joint IDA-IES “Five Principles for Responsible Outdoor Lighting”. By applying these principles, properly designed electric lighting at night can be beautiful, healthy, and functional. Projects that incorporate these principles, whether a residential home, a development, community, or region, will save energy and money, reduce light pollution, and minimize wildlife disruption.

    1 - DOES THE LIGHT SERVE A CLEAR AND NECESSARY PURPOSE?

    Light is useful for safe wayfinding and to help perform specific tasks. In the example below, the light illuminates only the entryway and stairs, where it is needed.

    If you find that lights on your property are not necessary or useful, remove or disable them so that they are not accidentally turned on.

    2 - DOES THE LIGHT FALL ONLY WHERE IT IS NEEDED?

    Direct the light down, not up into the sky, and target your fixtures so that light does not spill beyond where it is needed. From eye level, the light source should be even with, or recessed within, the light fixture, ensuring there is no visual discomfort known as glare.

    If the light spills beyond where it is needed, replace with a shielded fixture or re-orient the light so that it does not extend beyond where it is needed. Be especially mindful of light that spills up into the sky, or onto other people's property.

    3 - IS THE AMOUNT OF LIGHT APPROPRIATE FOR THE INTENDED TASK?

    Use the lowest lighting level needed to perform the task.

    Excessive light can contribute to glare, actually making it harder to see things well. If you find that the lighting level around your home is too bright for the task it is intended for, change the fixture's bulb to one with a lower light level or consider incorporating dimmers.

    4 - IS THE LIGHT CONNECTED TO ACTIVE CONTROLS?

    Switch off any exterior lights when possible. Light should only be used when needed to reduce the impact to the environment and save electricity.

    Outdoor lights that are necessary should be connected to a timer or motion sensor. Motion sensors should be set to times of 5 minutes or less. Dusk-to-dawn sensors are strongly discouraged as they release light when it is not needed.

    *Make sure sensor trigger sensitivity is set appropriately so that they light the area only when people are present.

    5 - IS THE LIGHT SOURCE WARM IN COLOR?

    Lightbulbs manufactured today have a Kelvin rating printed on the bulb or box. Low Kelvin ratings (3000 Kelvin or less) are considered warm and generally emit less harmful blue light than higher Kelvin. For home lighting, there are good options at 2700 Kelvin or less. Consider going as warm as possible, especially if you are in an ecologically sensitive area.

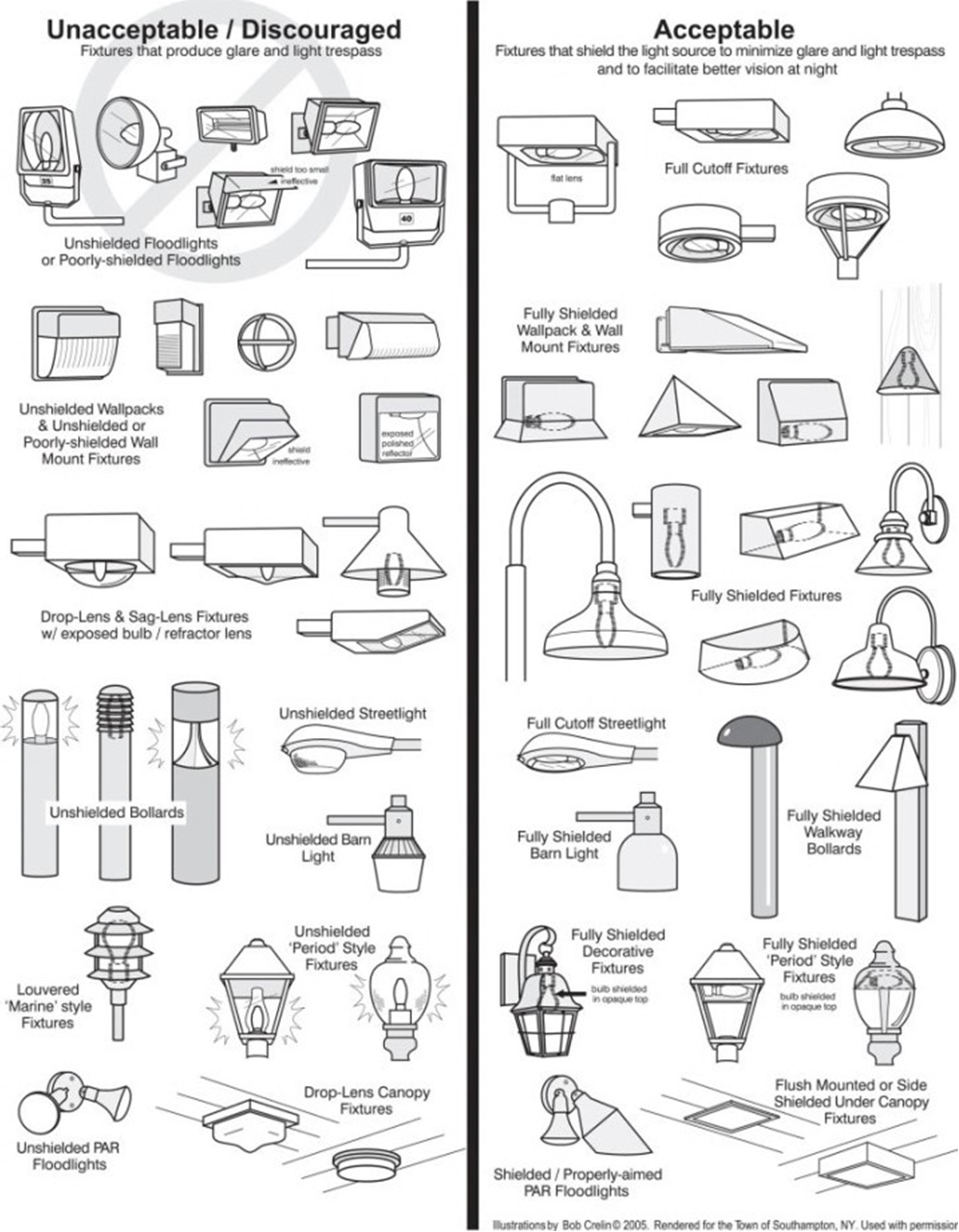

    Example Fixtures

    Notice

    I hereby certify that any non-compliant lighting shall be corrected and/or removed at no expense to the Town of Lakewood Village.

    I agree to the terms and conditions.
  • Utilities Application

    Utility applications are completed using an online submission form.

    https://www.lakewoodvillagetx.us/utilityapplication

    Notice
    I have completed and submitted an application for water and sewer utilities.
  • Utility Taps
    Water Tap

    The Town of Lakewood Village Public Works department is responsible for all service and repairs required for the water tap at the main line.

    Water Meter Set

    The Town of Lakewood Village Public Works department is responsible for setting the water meter and connection to the curb stop. The home builder is responsible for the installation of the service line from the meter to the home and the inspection is performed at plumbing rough.

    Sewer Tap

    The Town of Lakewood Village Public Works department is responsible for all service and repairs required for the sewer tap at the main line. The home builder is responsible for the installation of the lateral line from the stub out to the home and the inspection is performed at plumbing rough.

    The sewer tap is to be inspected a second time by the Town of Lakewood Village with a camera at Building Final. The Town of Lakewood Village shall be responsible for the scheduling of the camera inspection. The General Contractor shall be financially responsible for any repair and or clean out costs associated with the sewer tap if construction debris is found in the sewer line between the home and the sewer tap. The Certificate of Occupancy (CO) shall not be issued until the Town of Lakewood Village is reimbursed in full for all costs associated with the repair and or clean out of the sewer tap.

    Notice
    I hereby certify that I have read and understand the terms and conditions of the Town of Lakewood Village Utility Taps.
  • Energy Analysis
    Document Requirements
    1. Energy analysis (e.g., MecChech, ResCheck or Energy-Star).
    2. All third-party rater information and documentation shall be submitted if Energy Star Home.

    PDF format only.
  • Building Plans
    Document Requirements
    1. Submittal for approval house plans, containing lot dimensions, plan footprint, setbacks (front, sides and rear) complete address, lot number, block, and subdivision phase, easement locations, culvert drainage (if required), names of Engineers and Builders, finish pad elevations and finish floor elevations, topographical survey, driveways, sidewalks, fence locations, lot area, slab area and coverage percent. Utility and easement locations will also be required.
    2. Floor plans, elevations, framing, roof, electrical, mechanical (HVAC), plumbing and “to be built options” shall be clearly shown and detailed. Single sheet submittals are not acceptable. Options reflecting additional buildable space shall be identified by the actual square footage area and included in the permit values for total dwelling area and/or construction area under roof. Other options shown but red lined shall be included within the permit value.
    3. Elevation drawings shall clearly state exterior requirements set by the Town. Masonry calculations are an acceptable alternative (e.g., Front % + Right % + Left % + Rear % = total masonry %)
    4. All drawings shall be legible and show proper square footage for dwelling and total building areas.

    PDF format only.
  • Foundation Plans
    Document Requirements
    1. Submittal for approval house plans, containing lot dimensions, plan footprint, setbacks (front, sides and rear) complete address, lot number, block, and subdivision phase, easement locations, culvert drainage (if required), names of Engineers and Builders, finish pad elevations and finish floor elevations, topographical survey, driveways, sidewalks, fence locations, lot area, slab area and coverage percent. Utility and easement locations will also be required.
    2. Foundation designs and Engineer’s letters with original signature.
    3. All drawings shall be legible and show proper square footage for dwelling and total building areas.

    PDF format only.
  • Complete Submission
    Next Steps

    1. Copies of the submitted forms will be emailed to the authorized agent.
    2. The Town of Lakewood Village Building Department will review the building application for completeness.
    3. Once the buliding application is determined to be complete, The Town of Lakewood Village will contact the authorized agent with a fee schedule and payment instructions.
    4. Upon receipt of payment, the building plans will be reviewd by The Town of Lakewood Village's certified plans examiner.
    5. Approved plans with redlines and an approved building application will be returned electronically to the authorized agent.

    Questions

    Fees or Payments

    Direct questions to the Town Administrator @ linda@lakewoodvillagetx.us or (972) 294-5555.

    Application Submission

    Direct questions to the Building Administrator @ building@lakewoodvillagtx.us.

    Construction Process or Code Compliance

    Direct questions to the Chief Building Inspector @ inspections@lakewoodvillagetx.us.

    Notice

    I hereby certify that it is my responsibility to file all required forms with the Town, comply with all applicable building codes and Town Ordinances including but not limited to the ordinances listed in the Building Application.

    All fees shall be paid in full prior to issuance of a permit and commencement of work.

    I have reviewed the submittal documents for completness.
Selecting Multiple Files

Windows

To select multiple files on Windows, follow these steps:
  1. Click on one of the files or folders you want to select.
  2. Hold down the control key (Ctrl).
  3. Click on the other files or folders that you want to select while holding the control key.
  4. Continue to hold down the control key until you select all the files you want.

Mac

To select multiple files on Mac, follow these steps:
  1. Click on one of the files or folders you want to select.
  2. Hold down the command or shift key.
  3. Click on files or folders that you want to select while holding the command or shift key.
  4. Continue to hold down the command or shift key until you select all the files you want.

Android

To select multiple files in list or gallery view, follow these steps:
  1. You press and hold a file to select it and a check mark will appear next to it when it is selected.
  2. To select multiple files press on as many files as you want to select and check marks will appear next to all of the selected files.

iPhone / iPad

To select multiple files in list or gallery view, follow these steps:
  1. Select in the top-right corner.
  2. Tap each of your files.
